Contents
A realistic software project estimate is really just a forecast β your best statement of the time and resources a project needs, based on everything you know right now. And a defensible forecast is not a moment of inspiration; it’s the output of a process. The one this guide walks through is the one I use in my own consulting engagements: a fixed-scope discovery pass with a deadline and a price, a written findings document that pins down scope, risks, and assumptions, and a milestone-based quote built on top of it. Skip a stage and you’re not estimating β you’re guessing with confidence.
The Agony and Ecstasy of Software Estimation

It’s the question that kicks off that familiar dance between optimism and dread: “So, how long will this take?”
You feel caught between giving a number that makes a client happy and one that won’t sentence your team to a month of sleepless nights. But that moment is also your first real chance to build trust β because how you arrive at the number says more than the number itself.
A software estimate isn’t just a technical calculation; it’s a profoundly human activity, riddled with cognitive biases and external pressures. Optimism bias is the big one: we instinctively believe things will go smoother than they ever actually do, and past experience with “similar” features quietly hides the differences β a changed third-party API, a new compliance requirement β that end up dominating the schedule. Industry surveys have found, year after year, that the majority of software projects overrun their original time or budget. This is a systemic problem, not a talent problem.
An estimate is not a promise carved in stone. It is a probabilistic forecastβa statement of likelihood based on the information you have right now.
Viewing estimation this way changes everything. The goal isn’t a single “correct” number; it’s a structured conversation about risks, assumptions, and priorities. A solid estimate is the bedrock of a successful project:
- Trust with Stakeholders: It sets realistic expectations and shows you’ve done your homework.
- Healthy Team Culture: It protects your developers from the burnout that comes with impossible deadlines.
- Successful Delivery: It gives everyone a realistic roadmap for planning and execution.
Stage One: A Fixed-Scope Discovery, Not a Number
The single biggest upgrade you can make to your estimation process is refusing to produce a number before someone has done the looking. The first deliverable of any serious estimate is not a figure β it’s a time-boxed investigation with a defined output.
In my consulting practice this takes the shape of a fixed-scope audit: I read the code and the data, run the actual query plans instead of guessing at them, and deliver a ranked, written findings document β usually inside a week β followed by a walkthrough call. The services page describes how these run, and the reasoning behind pricing the diagnostic stage as a fixed fee is its own post: Software Development Cost Estimation Doesn’t Have to Be a Lie.
Three properties make a discovery pass work, whoever performs it:
- It’s time-boxed. A deadline (a week is usually right for a codebase-sized question) prevents discovery from becoming an open-ended research project.
- It’s scoped in writing before it starts. Even the investigation gets a defined shape β which systems, which questions, which deliverable.
- It produces a document, not a meeting. Findings that only exist in a call evaporate. A written artifact is what the next two stages are built on, and it’s what survives when people change or memories differ.
In-house teams can do exactly the same thing with a spike: a budgeted, time-boxed ticket whose deliverable is knowledge, written down. What matters is that the organization treats “understanding the work” as work.
Stage Two: Breaking Down The Beast
A software project estimate is only as good as your understanding of the work. You can’t put a number on a vague idea β so the discovery output has to transform high-level feature requests into a map of tangible, measurable tasks. Stop just accepting feature requests and start acting like a detective: the job is to uncover the complexities and assumptions lurking beneath the surface.
Beyond User Stories: The Work Breakdown Structure
User stories are great, but they often focus only on the happy path from a user’s perspective. A Work Breakdown Structure (WBS) goes deeper β a hierarchical deconstruction of the entire project into pieces small enough to actually estimate.
“Build a user login feature” is a classic epic. A WBS dismantles it into concrete tasks:
- Design the UI for the login and registration forms.
- Develop the front end components for input fields and buttons.
- Create the API endpoint for user authentication.
- Set up the database schema for storing user credentials securely.
- Implement password hashing and security protocols.
- Write unit and integration tests for the authentication flow.
Each item is far easier to reason about than the original request. Getting to this level means asking the questions that feel “stupid” β two stakeholders can hold entirely different definitions of a word like “real time,” and the gap between those definitions is schedule risk hiding in plain sight. Ask everything, and write the answers into the findings document.

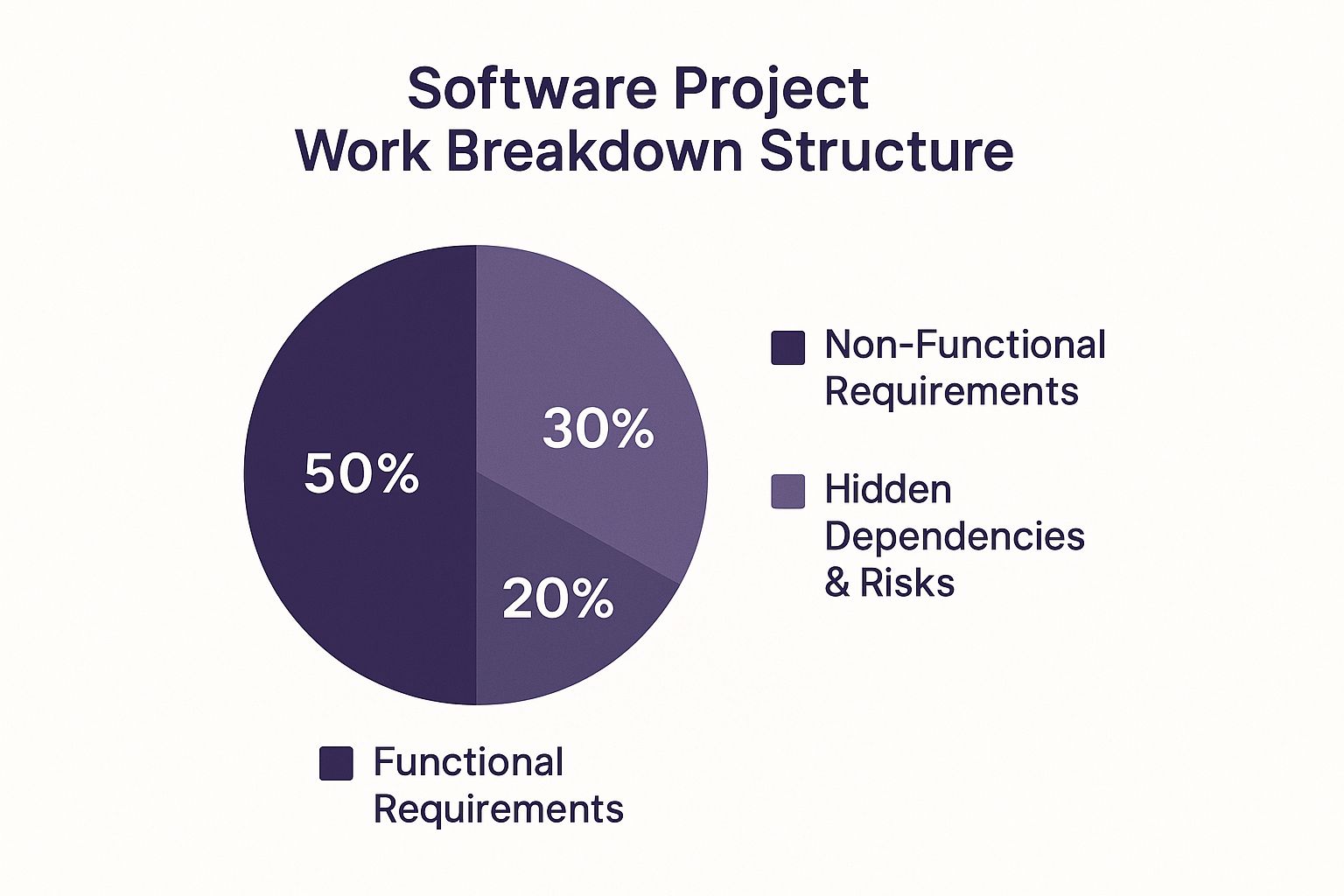

The infographic below illustrates how a project’s work distributes once you break it down.

The point the visual makes: user-visible features are only part of the work. Non-functional requirements, hidden dependencies, and risk mitigation claim a substantial share of any honest breakdown β and they’re exactly the items that vanish from an estimate built off a feature list alone.
Uncovering The Hidden Killers
The most dangerous parts of any project are the things you don’t see coming. The discovery stage’s real job is converting unknown unknowns (risks you don’t know exist) into known unknowns (risks you can identify and plan for).
Your goal is to turn “unknown unknowns” (risks you don’t even know exist) into “known unknowns” (risks you can identify and plan for).
That means digging into non functional requirements β not specific functions, but the qualities of the system, and often the true budget killers. There’s a detailed guide to testing software requirements before you write a single line of code that covers the validation side. Force clarity with questions like:
- Performance: What are the expected response times under peak load? How many concurrent users must the system support?
- Security: What are the compliance requirements (like GDPR or HIPAA)? What are the potential threat vectors we need to defend against?
- Scalability: How will the system handle growth over the next two years? What is our strategy for adding more resources?
By breaking down the work and forcing these conversations early, estimation becomes a structured, analytical process. The task map is the solid ground the numbers stand on.
Choosing Your Estimation Weapon Wisely

There is no silver bullet technique. Anyone who tells you their method is the only right way is probably selling something. The best technique fits your team, the project’s stage, and what stakeholders need to see β and estimates increasingly get audited, whether by an investor’s technical due diligence or by your own retrospective. Build them like someone will check the work.
Parametric Estimation: Your Data Driven Ally
Parametric estimation is a fancy way of saying you use historical data to predict the future β a formula built from your team’s past performance. Story points, function points, or delivery metrics become inputs: if your team consistently completes about 25 story points per two week sprint and a new epic sizes to 100 points, you have a data backed starting point of roughly four sprints. Its accuracy is only as good as the consistency of your historical data, which is why the record-keeping habit later in this guide matters.
Analogous Estimation: When History Rhymes
Sometimes you don’t have granular data, but you have a strong sense of dΓ©jΓ vu. Analogous estimation looks at a new task and says “this resembles that feature from last year,” then adjusts. It leans on expert judgment, which makes it fast and perfect for early ballparks β a team-level rule of thumb like “a simple CRUD screen is about a week for a senior dev” is analogous estimation doing honest work. The discipline is being brutal about the differences between then and now: stack, team, requirements maturity. Every difference adds uncertainty.
Three Point Estimation: Embracing Uncertainty
The technique that forces an honest conversation about risk. Instead of one number, provide three:
- Optimistic (O): The absolute best case. No roadblocks, no unexpected bugs.
- Most Likely (M): The realistic path, with the usual meetings, minor issues, and friction.
- Pessimistic (P): Murphy’s Law in full effect β key people sick, a critical library deprecated mid sprint.
A weighted formula like PERT β (O + 4M + P) / 6 β turns the three into a defensible average, and the exercise itself shifts the conversation from “will you hit this exact date?” to “what’s our confidence level, and how do we mitigate the biggest risks?”
Comparison of Estimation Techniques
| Technique | Best For | Pros | Cons |
|---|---|---|---|
| Parametric | Mature teams with good historical data and repetitive tasks. | Data driven, objective, and often highly accurate. | Requires clean, consistent historical data to be effective. |
| Analogous | Early stage projects, quick ballpark figures, or when detailed requirements are unavailable. | Fast, simple, and leverages expert experience. | Highly subjective and only as good as the expert's memory and the chosen comparison project. |
| Three Point | Complex tasks or projects with high uncertainty and risk. | Acknowledges risk, forces a discussion about uncertainty, provides a realistic range. | Can be more time consuming to gather three separate estimates for each task. |
Choosing a technique isn’t a one time decision. Start with analogous for the initial framing, move to parametric for sprint planning, and reach for three point on the risky R&D pieces. The goal is confidence, not a crystal ball.
The Secret Sauce: Using Historical Data
Your past projects are a goldmine of estimation data, and most teams let it go to waste β the project ships, everyone exhales, and the insight evaporates into the next fire. Building the record doesn’t require expensive software; it requires a habit.
What Metrics Actually Matter?
Forget tracking every minute β that’s a recipe for burnout. Focus on a few high impact metrics that tell a story about how your team works:
- Team Velocity: For teams using story points, the average completed per sprint. Simple, powerful, and a great measure of delivery cadence.
- Cycle Time: How long a task takes from “In Progress” to “Done.” Excellent at revealing bottlenecks β high cycle time usually means work stuck in review, QA, or dependencies.
- Bug Rate: How many bugs or regressions surface per shipped feature. A high rate is a signal to buffer more QA time in future estimates β not a judgment, just a reality of the current process.
Building Your Estimation Knowledge Base
The format that works is embarrassingly simple: a shared page where, after each major feature, someone spends thirty minutes recording three things.
- The Original Estimate: What you thought it would take (e.g., 40 story points, 3 weeks).
- The Actual Outcome: What it really took (e.g., 55 story points, 5 weeks).
- The “Why”: What caused the difference β a surprise API change? Underestimated UI complexity? A dependency nobody flagged?
Before starting anything new, check the record. “This class of integration ran long last time β account for it from the start” is worth more than any formula, because it’s your data about your team.
This isn’t about blaming anyone for being wrong. It’s collective memory β and it naturally absorbs nuances like team changes or a new stack, because you can see how those factors played out before. Every project, successful or delayed, becomes a lesson that sharpens the next estimate.
Stage Three: From Findings to a Milestone Quote
Here’s where the process pays off. With a findings document in hand β decomposed scope, named risks, explicit assumptions β you can quote in a way that a from-thin-air estimate never allows: milestone by milestone.
The shape that works:
- Each milestone is independently testable. Not “50% done” β a deliverable someone can exercise and accept: “authentication flow live on staging, passing the agreed test cases.” If a milestone can’t be verified, it isn’t a milestone; it’s a hope.
- Near milestones are priced precisely; far ones are ranged. The first milestone or two sit on well-mapped territory, so they carry firm numbers. Later milestones inherit more uncertainty and carry ranges β which narrow at each boundary as reality replaces assumption.
- Re-estimation is scheduled, not an apology. The end of each milestone is a planned checkpoint to re-quote what remains. This converts “the estimate changed” from a crisis into an agenda item.
- Changes go through written change control. New requests get evaluated, estimated, and approved against the written scope before code is written. You cannot control changes to a scope nobody wrote down.
This is exactly how builds work in my own practice: quoted in writing after the audit, milestone by milestone, so the client has the cost on paper before we start and a verification point at every step. The pricing rationale β why the diagnostic stages carry fixed fees while the build is quoted only after them β is covered in the companion post on cost estimation.
Communicating Estimates and Managing Expectations

Creating the software project estimate is only half the battle. The other half β the one that defines success β is presenting it. This is where technical work meets human psychology, and a number without context is just a target for blame when things go sideways.
Frame the Conversation Around Ranges
The single most effective technique for managing expectations: stop giving single numbers. Present every estimate as a range tied to a confidence level. Instead of “this will take three months,” try: “Based on our current understanding, we are 80% confident this will take between 10 and 14 weeks.”
This phrasing accomplishes several things at once:
- It acknowledges uncertainty: You’re being upfront that the future isn’t 100% predictable.
- It creates a buffer: The range naturally includes contingency without you having to say you’re adding “padding.”
- It invites the right questions: The follow up is no longer “Why so long?” but “What are the risks that push us toward 14 weeks?”
Make Your Assumptions Crystal Clear
Every estimate is built on assumptions, and if they turn out wrong, the estimate crumbles. State them upfront, clearly and without apology β this is why the written findings document earns its place, because the assumptions live in it rather than in someone’s memory of a call.
Your list of assumptions is also your list of risks. When you say, “We assume the third party API will be stable,” you are also saying, “If that API is unstable, our timeline is at risk.”
Present the assumptions as part of the estimate and treat them as a discussion checklist with stakeholders. It turns them from passive recipients of a number into active partners in managing the project’s risk β a mindset worth building early, especially for founders navigating the chaos of the early stages. For more on that, see these things to know before starting a startup.
What to Remember for Your Next Estimate
The cheat sheet version, to tape to your monitor before the next estimation meeting:
- Discovery Before Digits. No number before someone has done the looking. A time-boxed, written discovery pass β audit, spike, whatever your context calls it β is the first deliverable, every time.
- Break It Down. Then Break It Down Again. Deconstruct every feature into small, tangible tasks, and hunt aggressively for the non functional requirements that never make the feature list.
- Pick the Right Tool for the Job. Analogous for the quick ballpark, parametric for well-understood work with good data, three point for the risky unknowns.
- Your Project History Is a Goldmine. Estimate vs. actual vs. why, written down every time. It’s the cheapest accuracy upgrade available.
- Quote in Milestones, Talk in Ranges. Testable milestones with firm near-term prices and ranged later ones, re-estimated at each boundary β and every assumption stated in writing.
A software project estimate is not a commitment carved in stone. It’s a transparent forecast based on what you know right now, designed to kickstart a strategic conversation about risk, value, and trade offs.
A Few Common Questions About Project Estimation
What’s the Best Estimation Tool Out There?
Honestly, the best tool is usually the simplest one that gets the job done. A basic spreadsheet is perfect for tracking historical data β estimated vs. actual β and a solid project management platform like Jira or Asana handles the day to day work. Teams that sink money into dedicated estimation software rarely move the needle, because the leverage is in refining the process, not adding another tool to the stack.
How Do You Estimate a Project with Brand New Technology?
You’re staring into the unknown and the business wants a hard number. The key: you aren’t estimating the final implementation; you’re estimating the investigation β which is the discovery-first principle applied at the task level.
- Spike Stories: Carve out a specific, time boxed task purely for research and prototyping. The deliverable isn’t code β it’s knowledge, written down.
- Timeboxing: Put a hard cap on the research phase β say, three days to explore the tech and return with a demo or a report. This prevents research from becoming an endless rabbit hole.
- Three Point Estimation: Tailor made for high uncertainty; it forces the best case / worst case / most likely conversation that new technology demands.
How Often Should We Re-Estimate a Project?
Estimation is not a one and done event performed at kickoff and framed on the wall. It’s continuous refinement. For agile projects this happens organically β upcoming work is re-discussed every sprint. For longer engagements, milestone boundaries are the natural re-estimation checkpoints: each completed milestone replaces assumptions with facts, so the remaining quote should be revisited there as a matter of routine. And any significant new information or scope change should trigger a re-estimation session regardless of the calendar. Continuous planning beats loyalty to a plan everyone knows is outdated.
Want the process, not just the theory? Most of my engagements start exactly as this guide describes β a fixed-scope audit with written findings inside a week, then a milestone-quoted plan. See how engagements run or the Django consulting page for specifics.
